SolverForge in practice
Turn competing demands into a workable plan.
Cover shifts with qualified staff. Fit lessons into rooms and timeslots. Route deliveries within capacity and time windows. Coordinate maintenance without sacrificing fleet readiness. These examples show how to model the rules a plan must obey and the goals worth improving — so you can find a starting point for your own scheduling, routing, or allocation problem.
Healthcare workforce coverage
688 shifts. 50 employees. 28 days of staffed coverage.

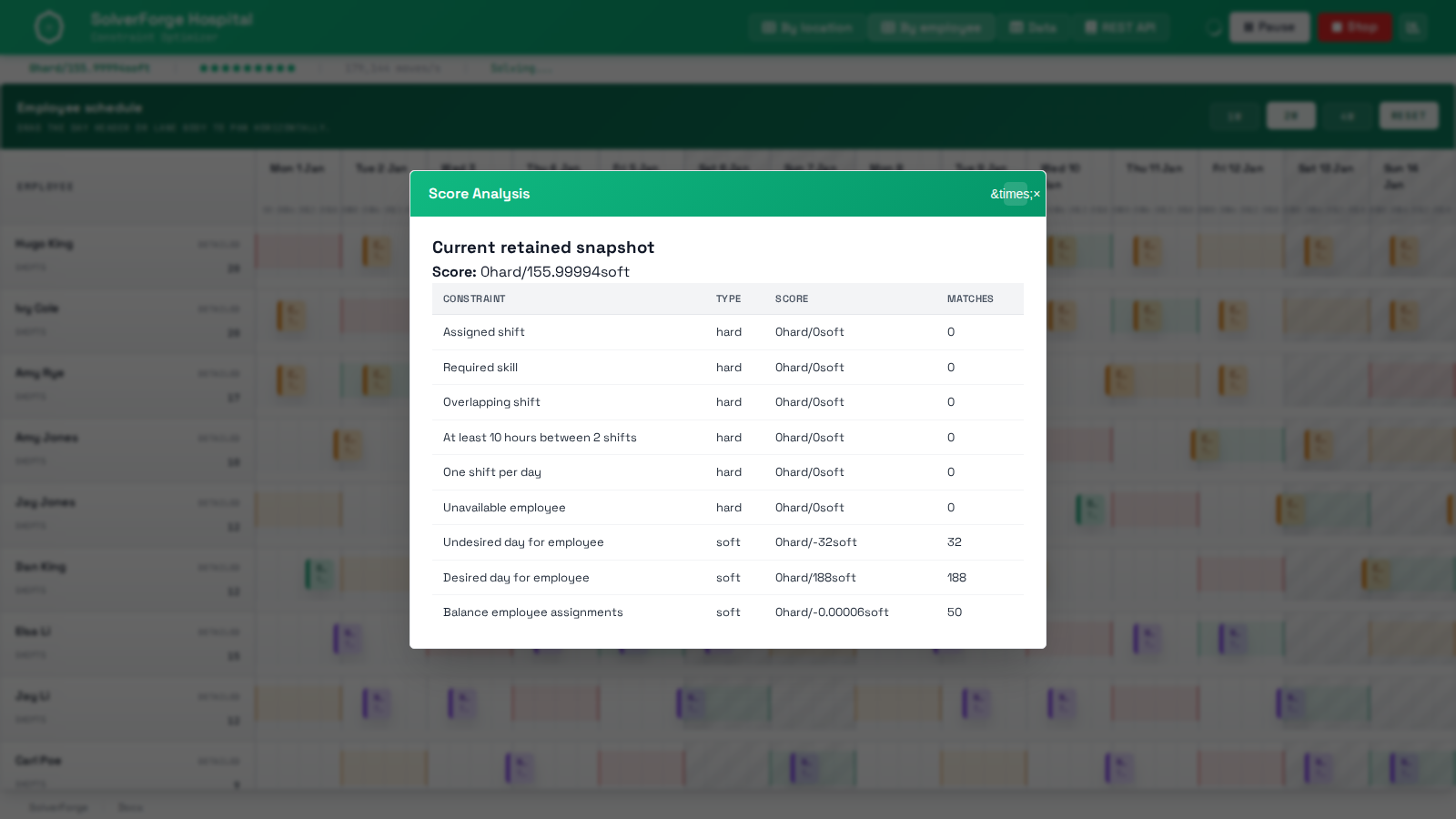

Hospital scheduling shows scalar assignment at serious density: every shift needs a qualified employee while overlap, rest, availability, preferences, and balance remain visible.
Coverage planning breaks when qualification, availability, rest, overlap, and fairness are handled by separate tools. A schedule that fills every slot but violates rest or skill rules is not operationally usable.
The current app keeps location schedules, employee schedules, solver status, score analysis, data tables, and REST endpoints available from the same retained job.

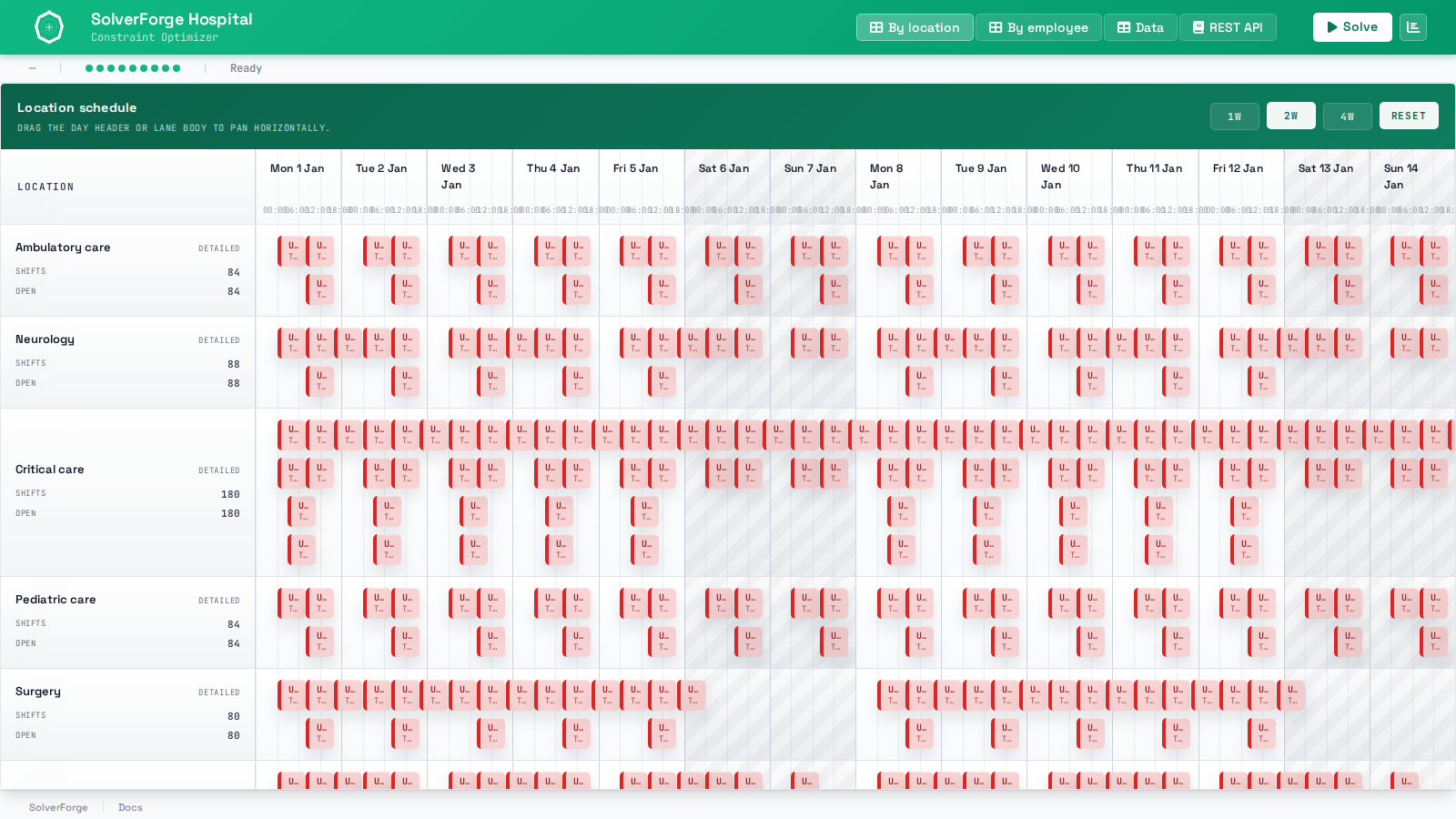

- 1 Department rows expose where coverage is required.
- 2 Dense shift placement stays visible across the 28-day horizon.

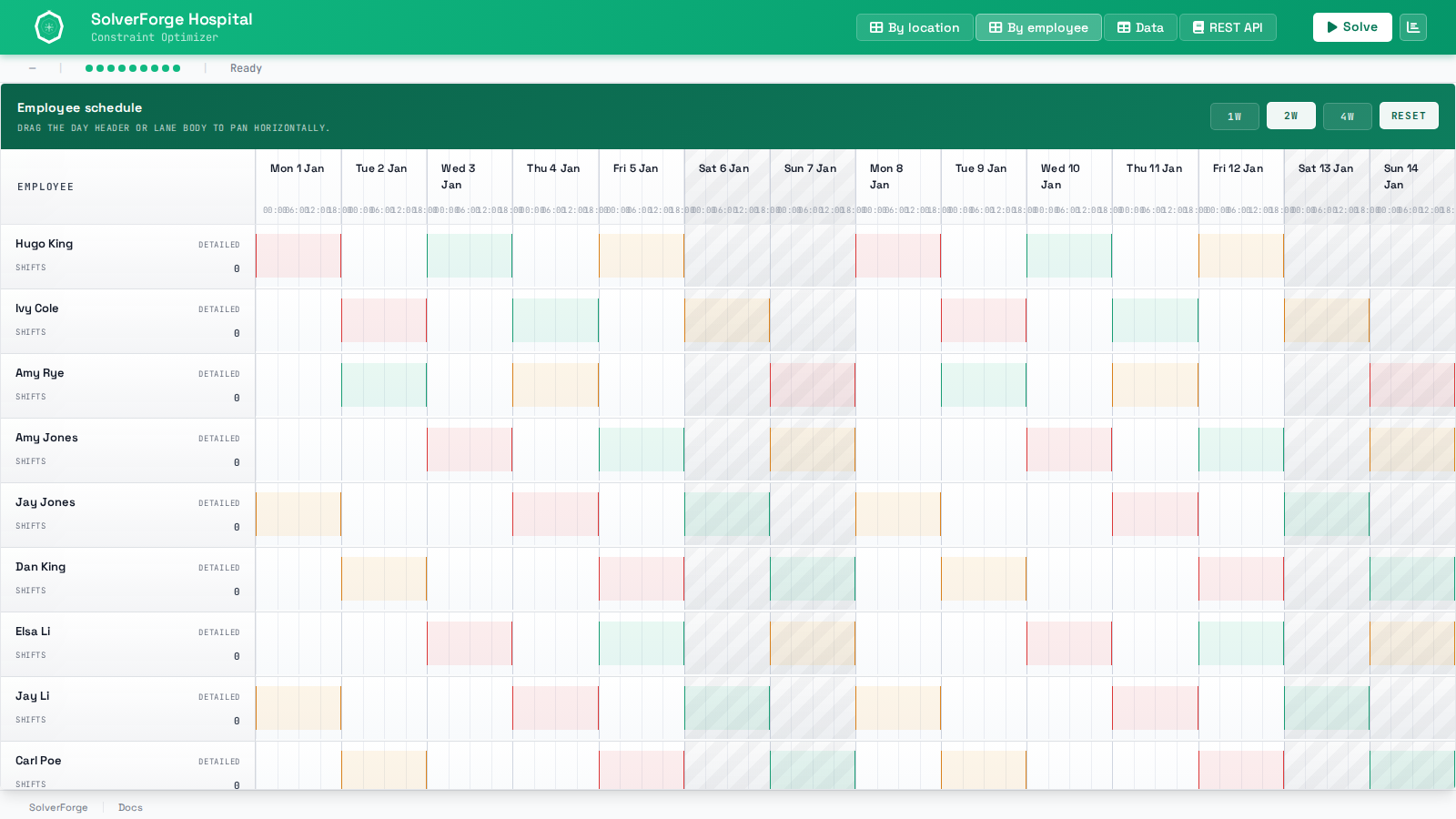

- 1 Employee rows expose workload and assignment spread.
- 2 The same retained job can be inspected by people instead of only by locations.

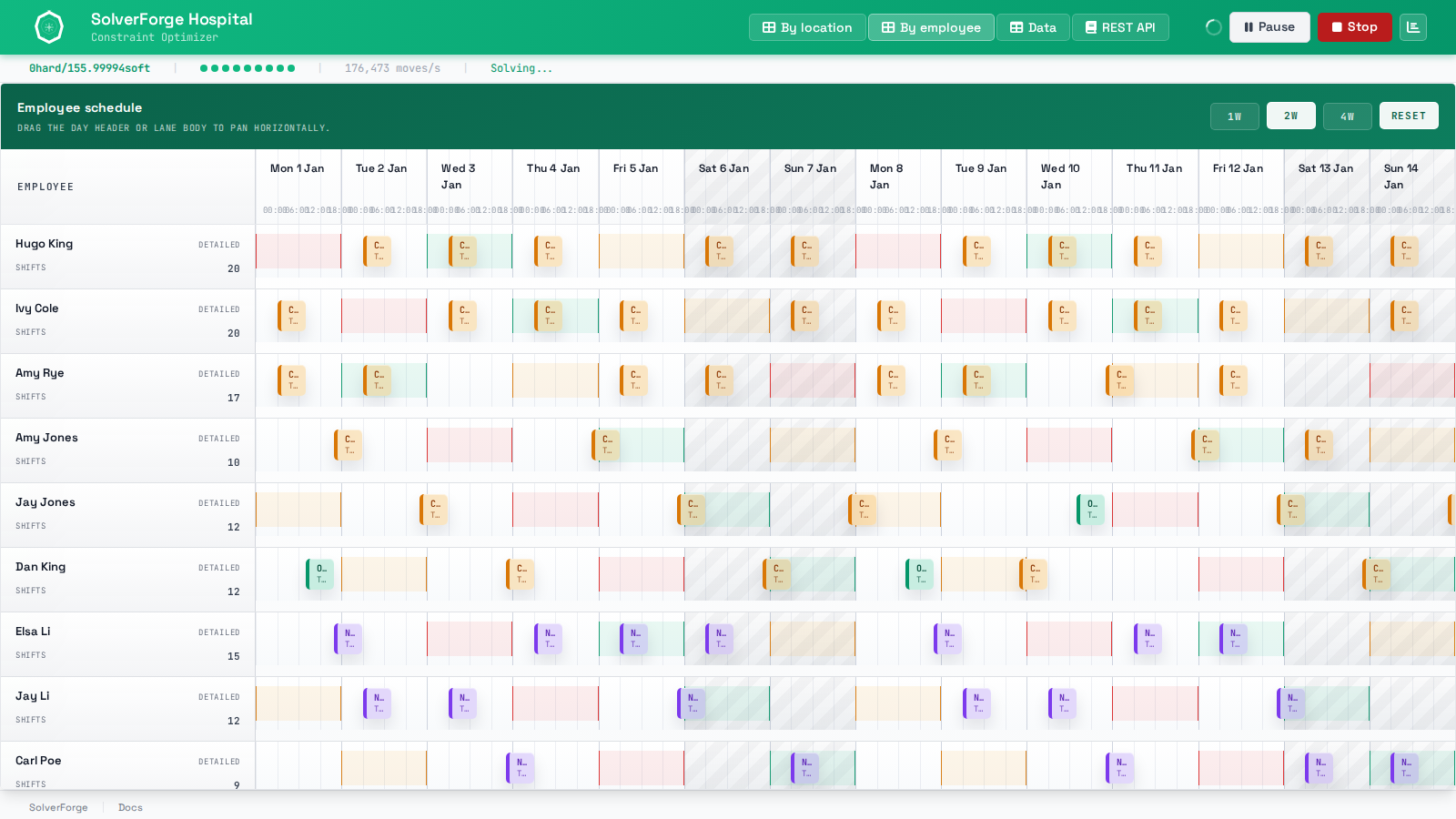

- 1 Status controls keep solve lifecycle explicit.
- 2 Telemetry remains visible while the schedule is being reviewed.
- 1 Hard staffing legality and soft balance are separated for audit.
- 2 Each row exposes contribution and match counts for review.

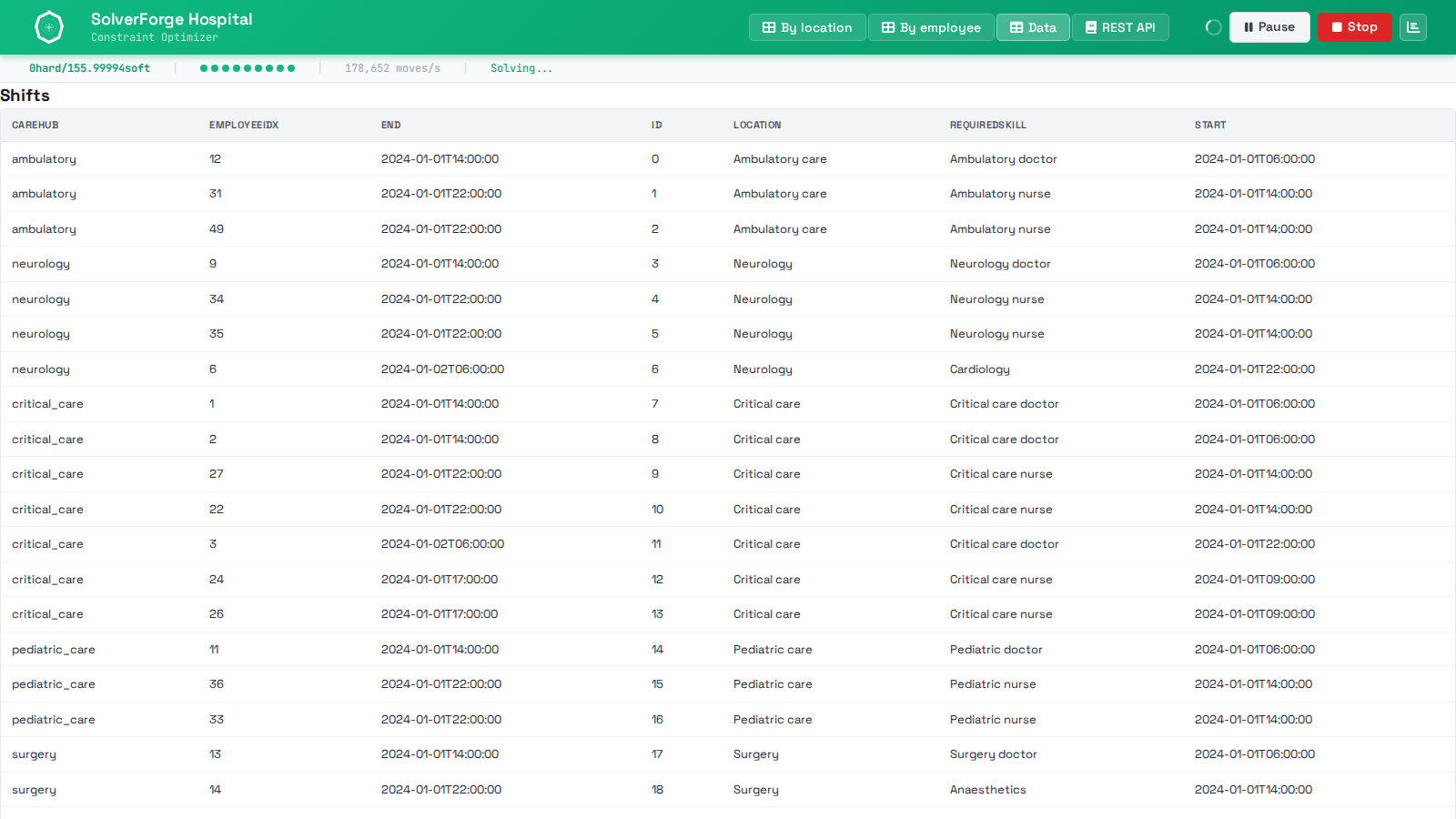

- 1 Employees, shifts, locations, and availability remain inspectable.
- 2 Input facts stay adjacent to the generated schedule surface.

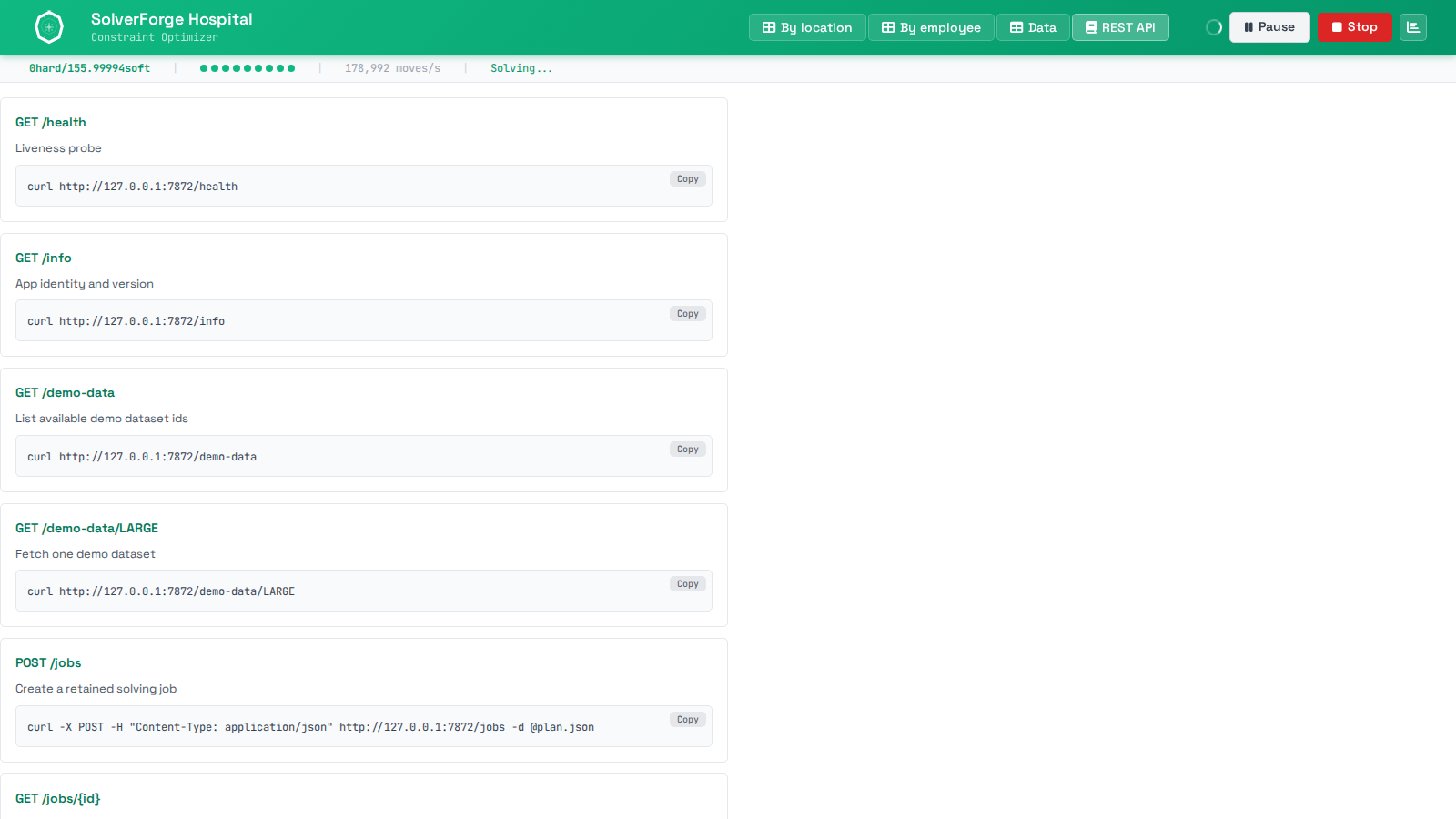

- 1 Endpoints expose solve creation, status, snapshots, and analysis.
- 2 The UI and integration API share the retained-job lifecycle.
School timetabling

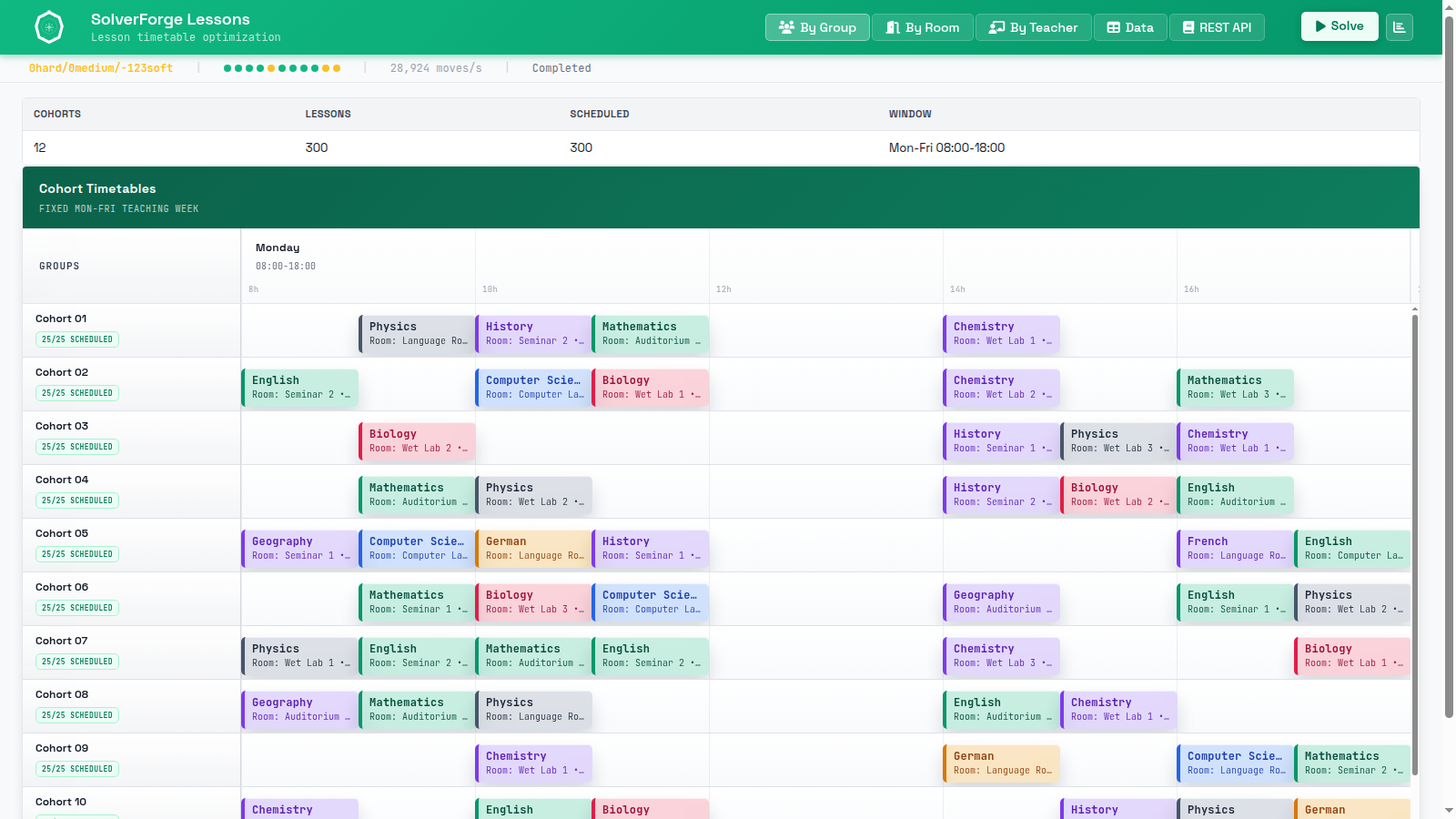

300 lessons. 12 cohorts. 20 teachers. One inspectable school week.

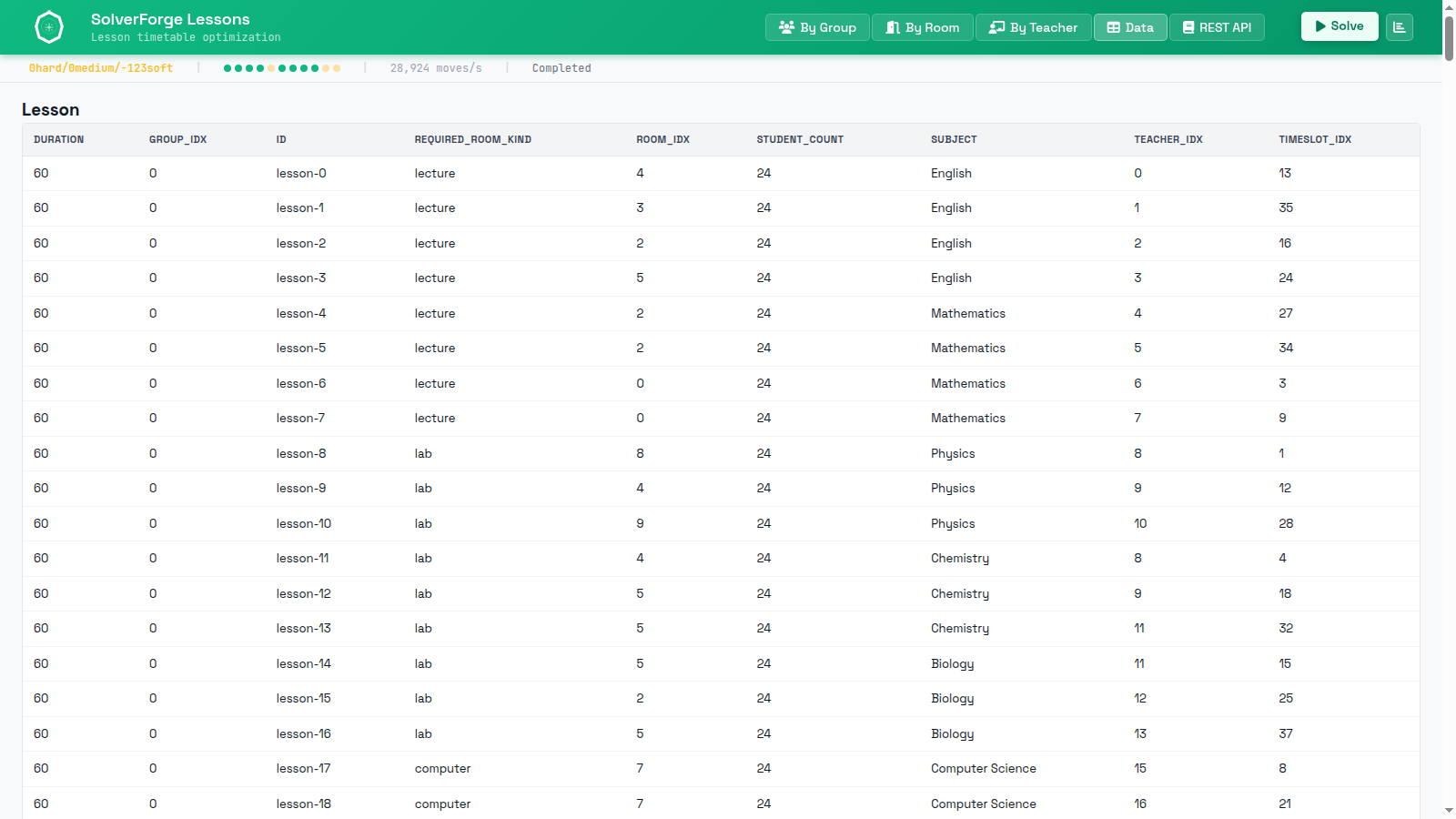

Lesson timetabling shows two scalar decisions per lesson: which weekly timeslot and which room. Teacher availability, cohort availability, room capacity, and single-booking rules hold at the same time as soft timetable quality.
A timetable is not a table of slots. Every lesson needs a room that fits the class, a teacher who is available at that hour, and a cohort that is not already booked. No teacher can teach two lessons at once, no cohort can be in two places, and no room can host a double booking.
The app keeps the generated week, the retained job, score analysis, the input tables, and the REST surface on one inspectable timetable: cohort, room, and teacher views are three readings of the same retained plan.
- 1 The status strip keeps lifecycle state, score, moves per second, and all 11 constraint dots visible.
- 2 Each scheduled lesson carries its room, teacher, and cohort inside the block.
- 1 Room lanes show how the building is used across the week.

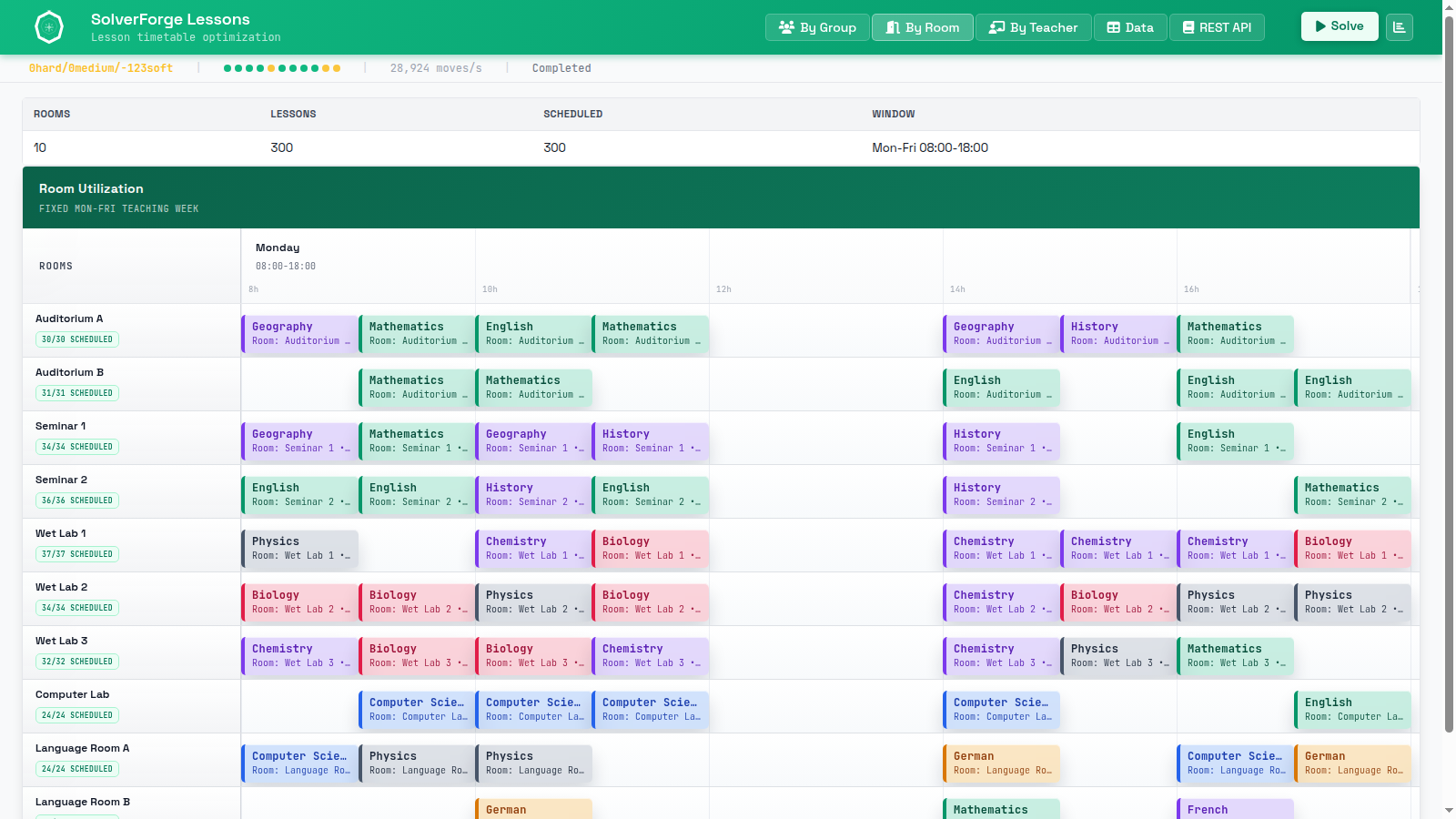

- 2 The same 300 lessons, read from the rooms instead of the cohorts.
- 1 Each view is one retained plan; only the grouping changes.

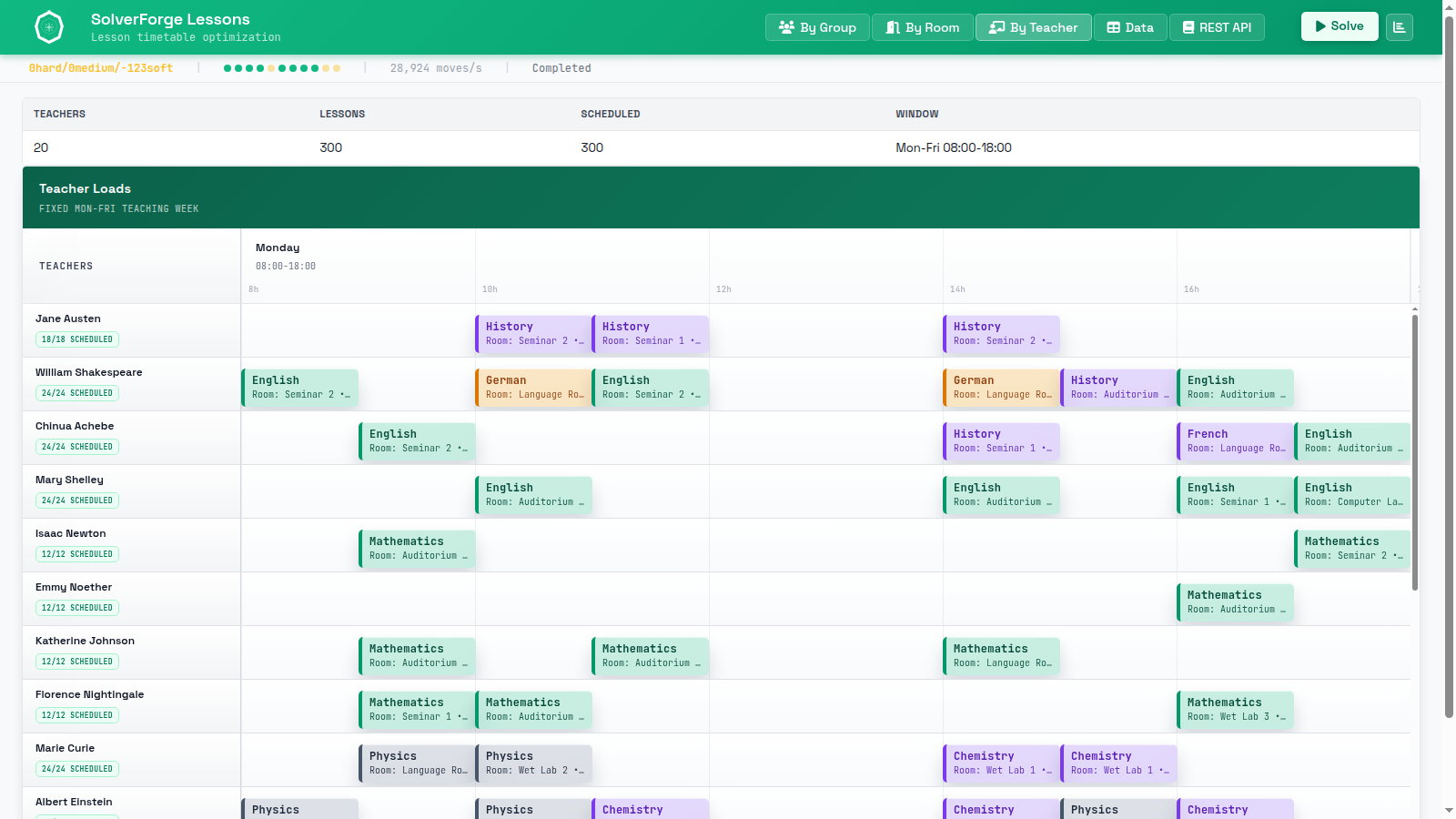

- 2 Teacher lanes expose that teacher's own week and load.

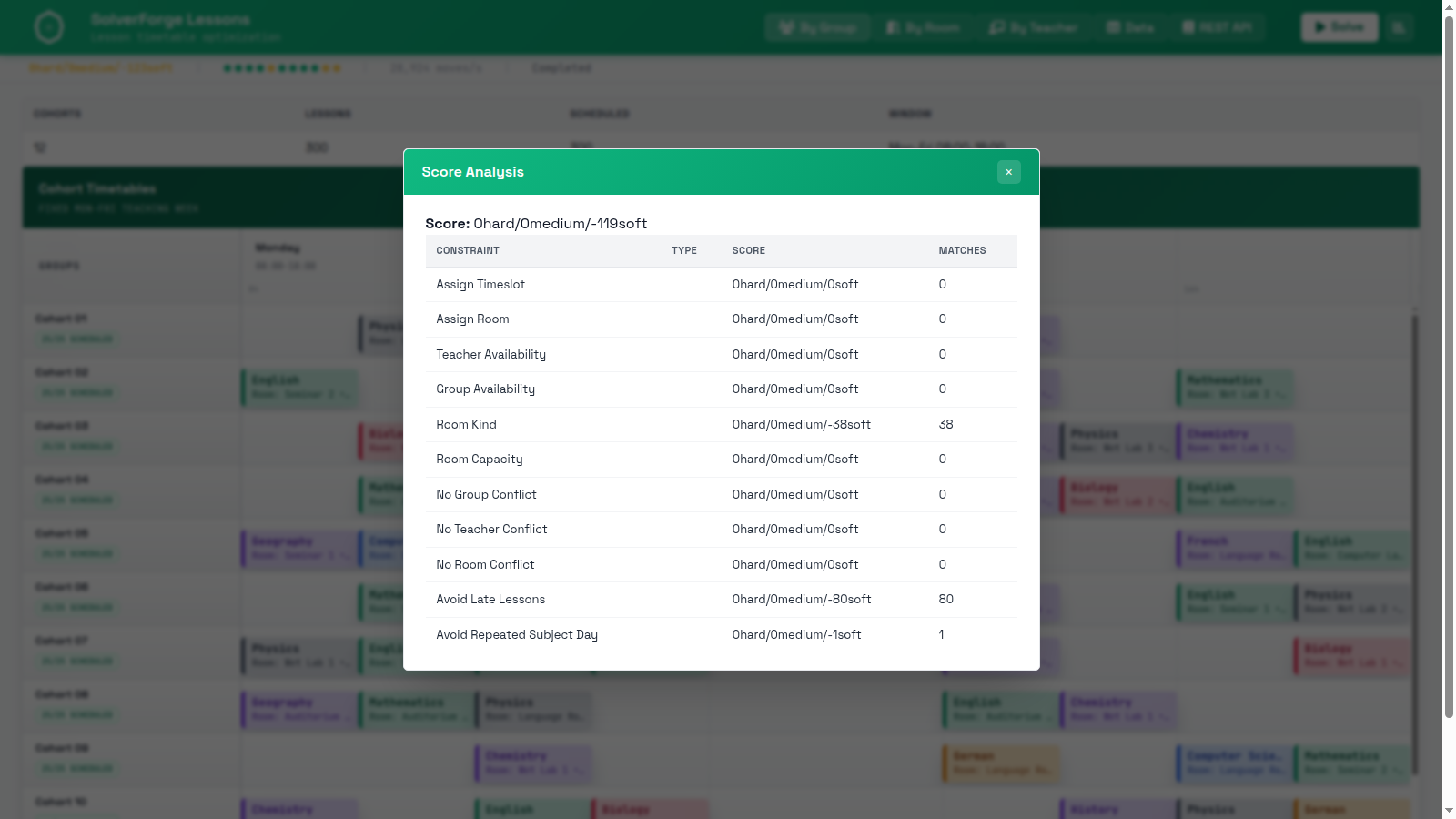

- 1 Hard, medium, and soft score components stay separate.
- 2 Soft pressure keeps its contribution and match count per constraint.
- 1 Input facts stay in the same surface as the generated plan.
- 2 Assignment columns show the chosen room and timeslot per lesson.

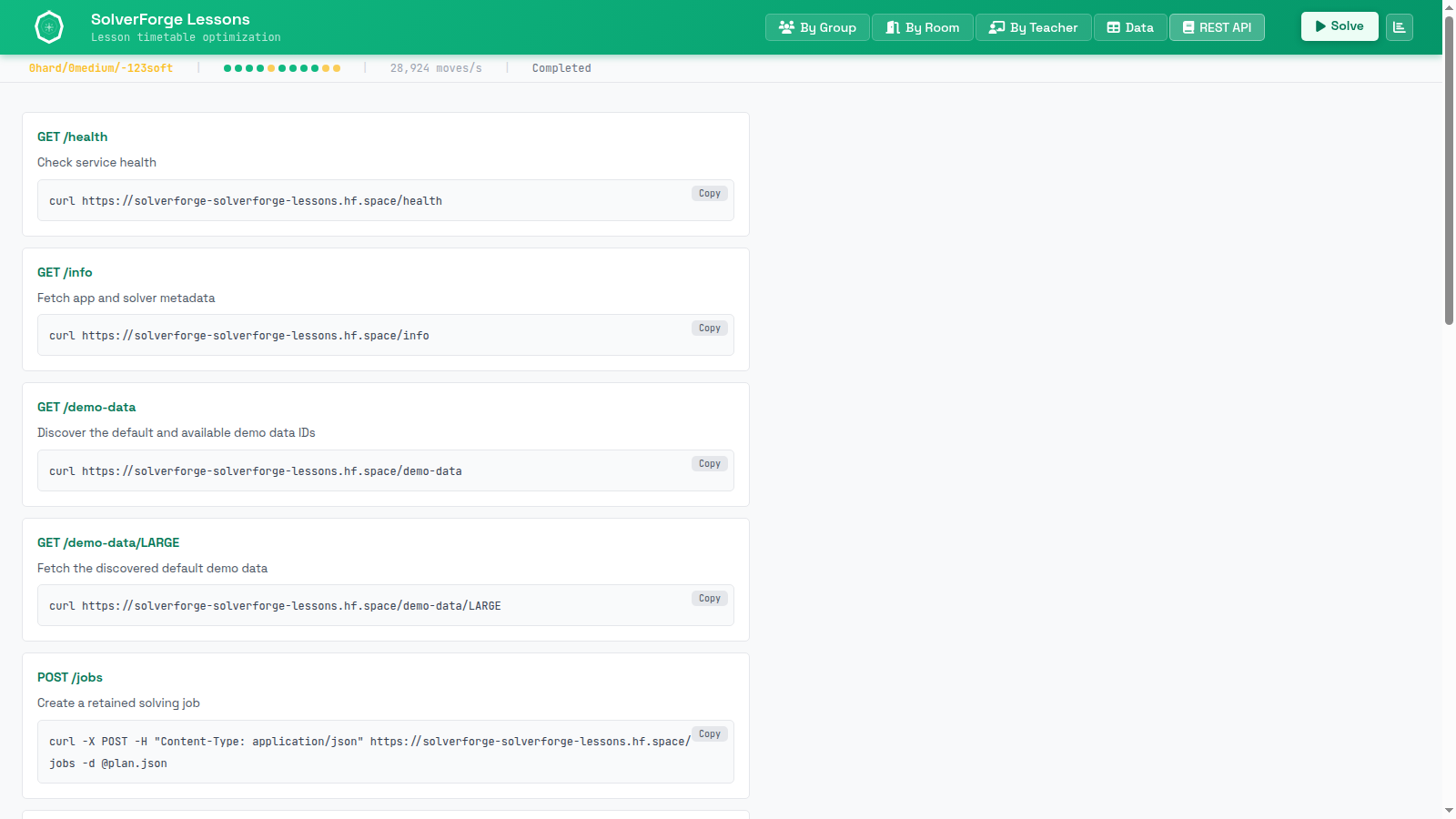

- 1 Every endpoint ships a copyable curl example.
- 2 Retained-job endpoints cover create, status, snapshot, analysis, and events.
Urban delivery routing

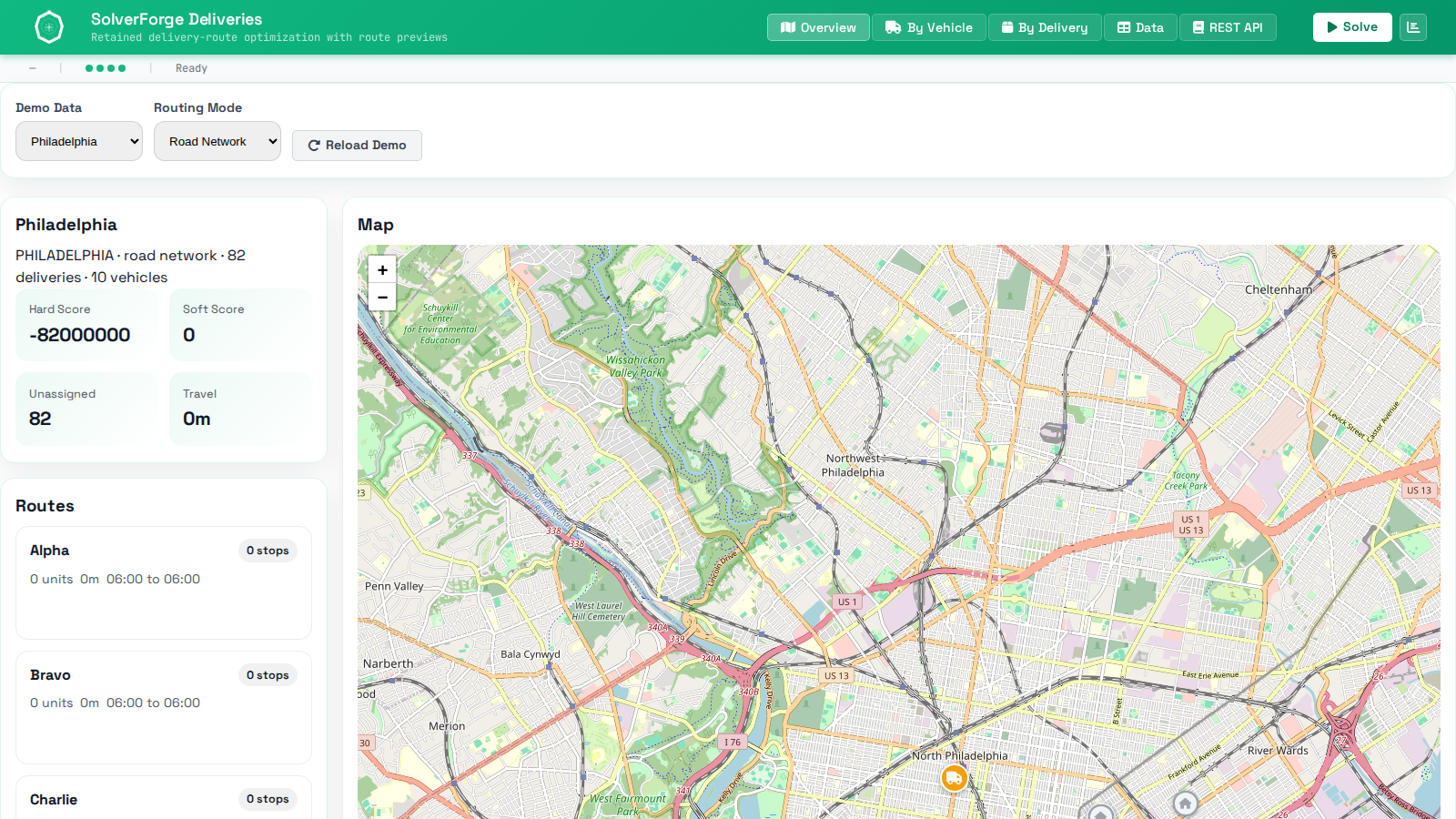

82 Philadelphia deliveries. 10 vehicles. Ordered routes you can inspect.
Delivery routing proves list-variable planning: each vehicle owns an ordered route while capacity, time windows, travel time, retained snapshots, route geometry, and insertion recommendations stay inspectable.
A delivery plan is not just assignment. Vehicle order matters, time windows matter, capacity matters, and changes need repair workflows that preserve useful route structure instead of throwing the plan away.

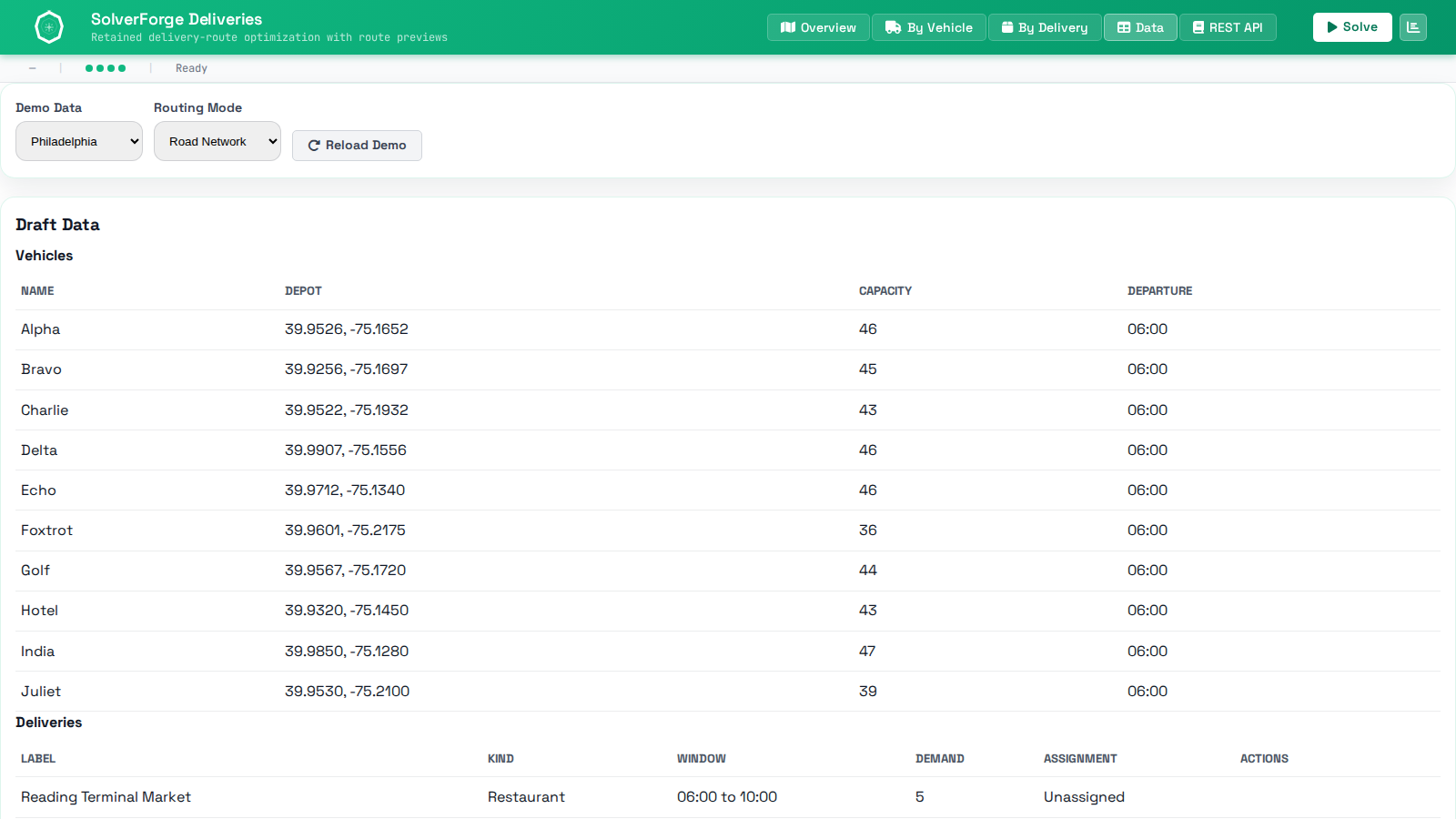

The current app exposes the route map, vehicle timeline, delivery timeline, recommendations, score analysis, retained snapshots, and REST endpoints as one planning surface.
- 1 Vehicle route cards keep stop order and load visible.
- 2 The map renders retained route geometry from the same solve snapshot.

- 1 Each lane owns an ordered route and capacity context.

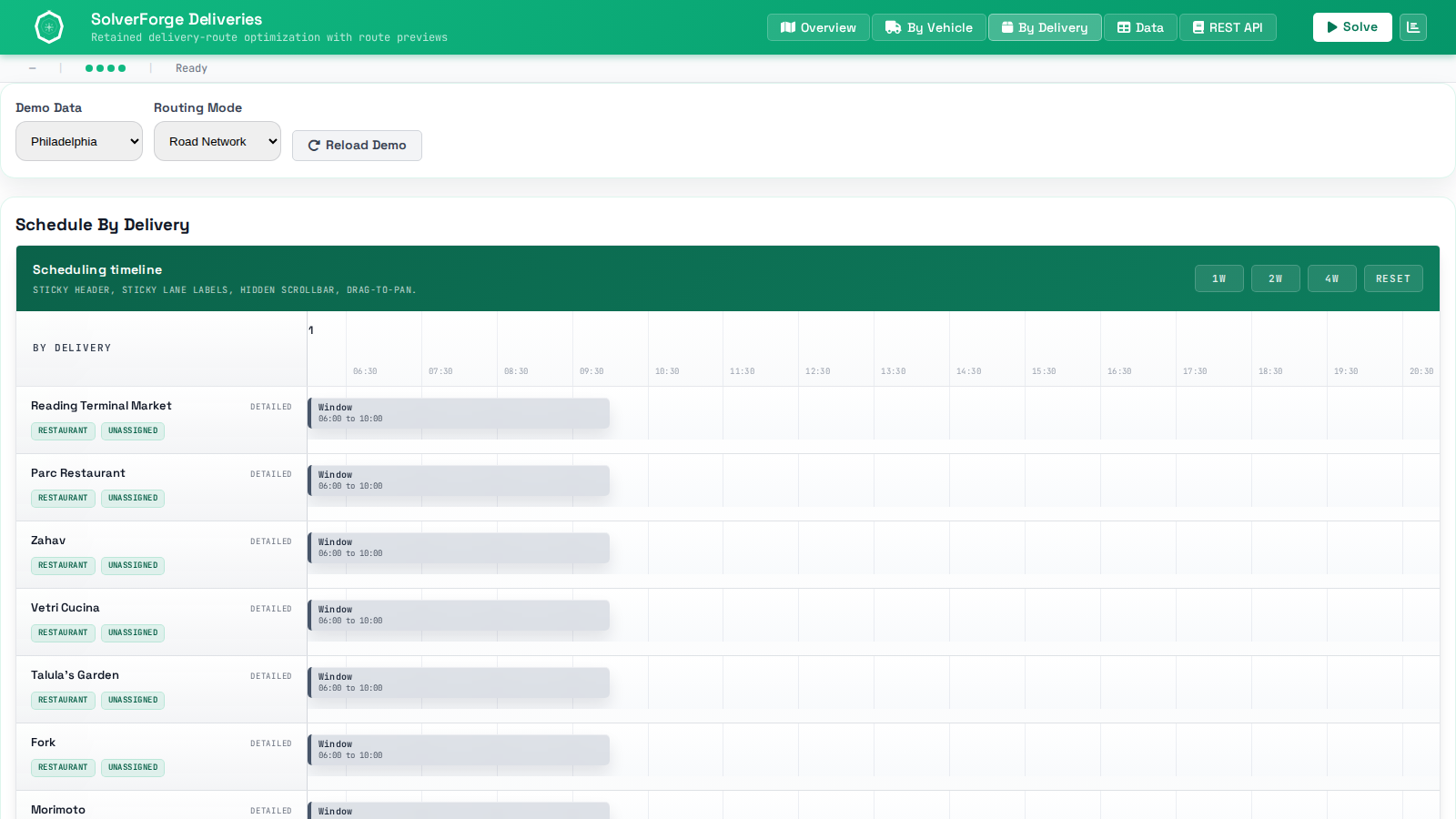

- 2 Timeline placement makes route density and idle gaps inspectable.
- 1 Delivery rows expose service-window and assignment context.
- 2 Time placement shows where the route sequence is under pressure.

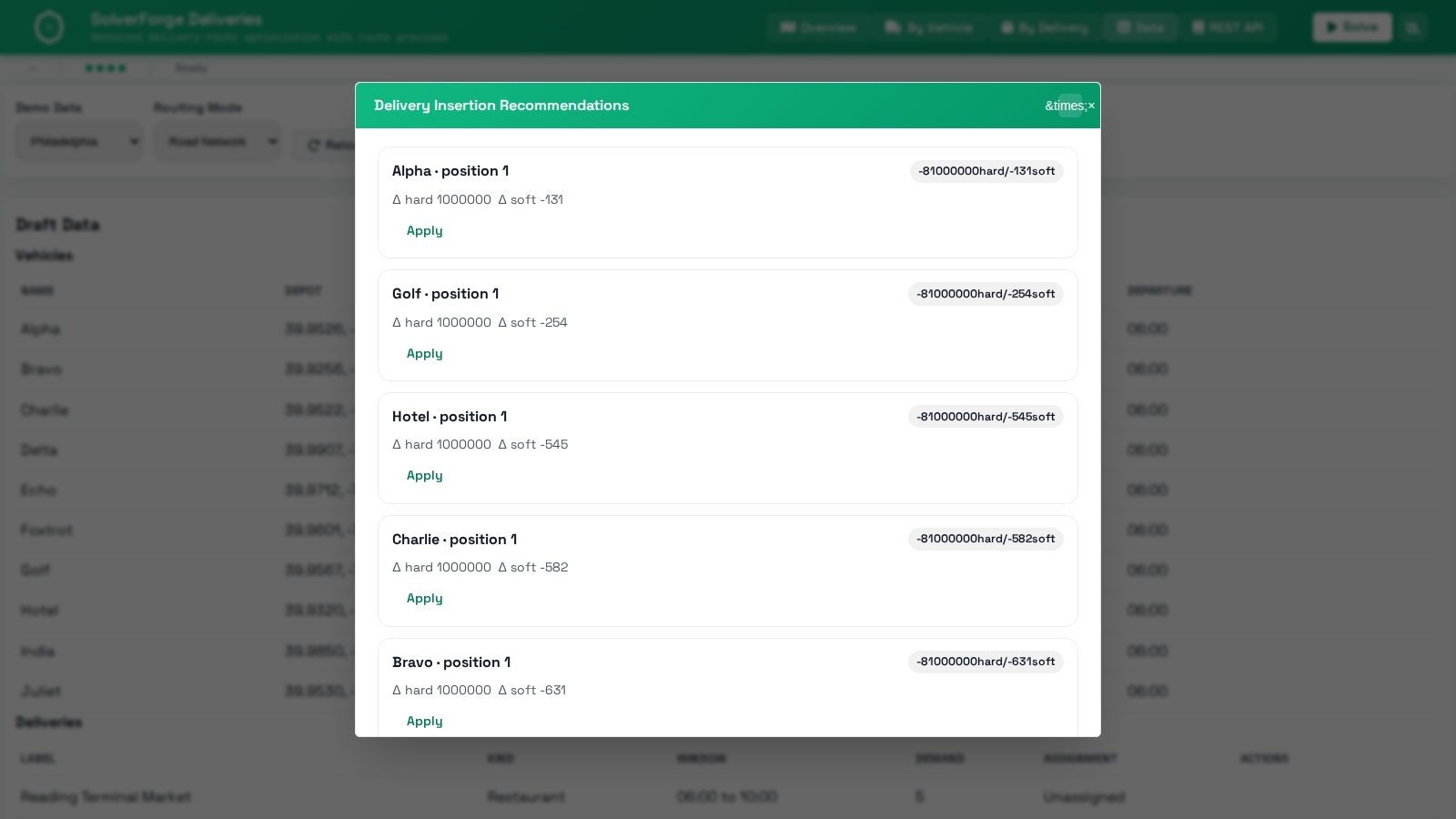

- 1 Insertion options are ranked before a user commits a repair.
- 2 The affected delivery remains visible while alternatives are inspected.
- 1 Hard constraints show whether the route plan is legal.
- 2 Soft travel-time pressure remains visible for tradeoff review.

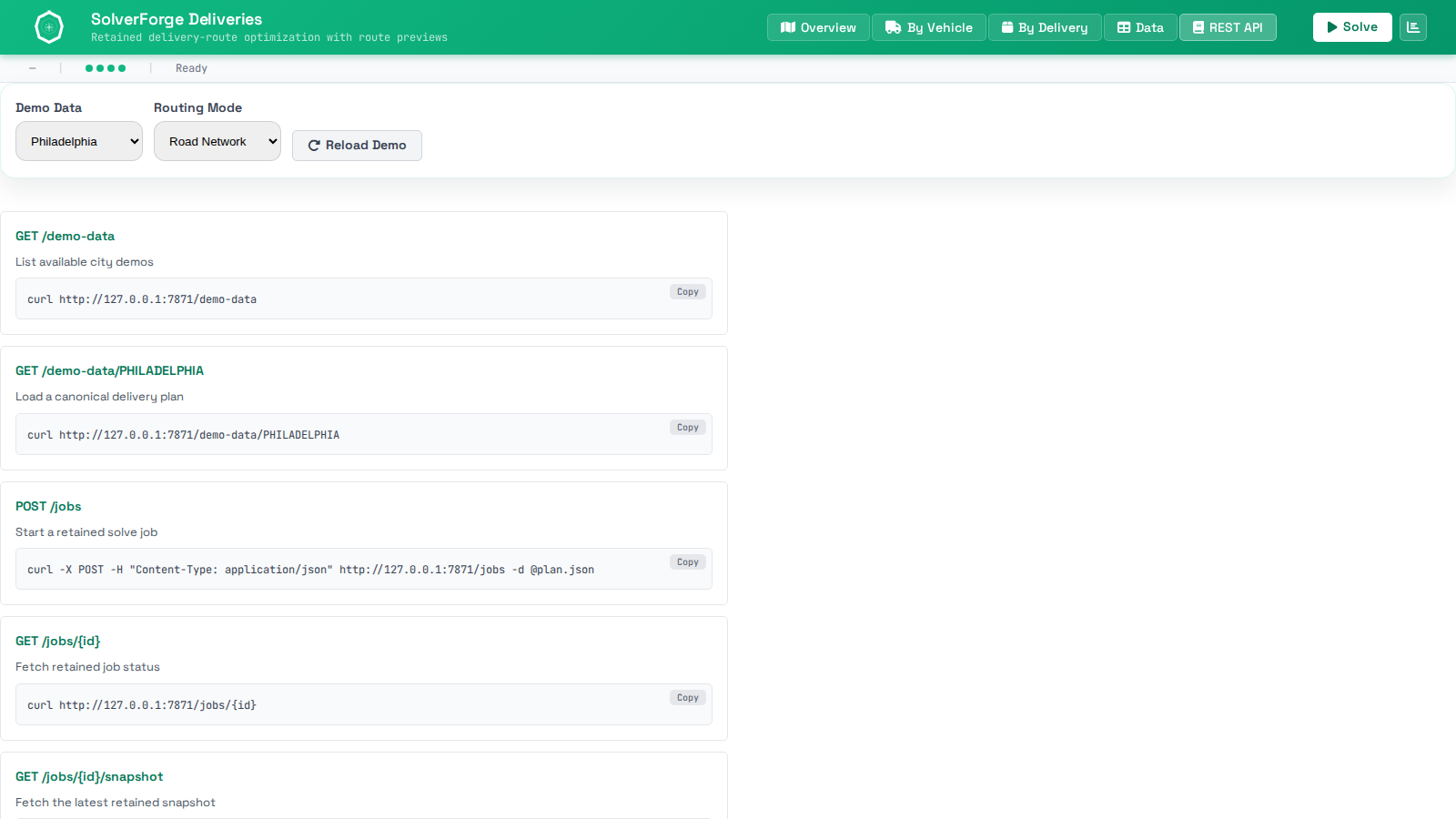

- 1 Retained-job endpoints expose creation, status, snapshots, and analysis.
- 2 Route and recommendation APIs keep repair workflows product-embeddable.
Field service routing

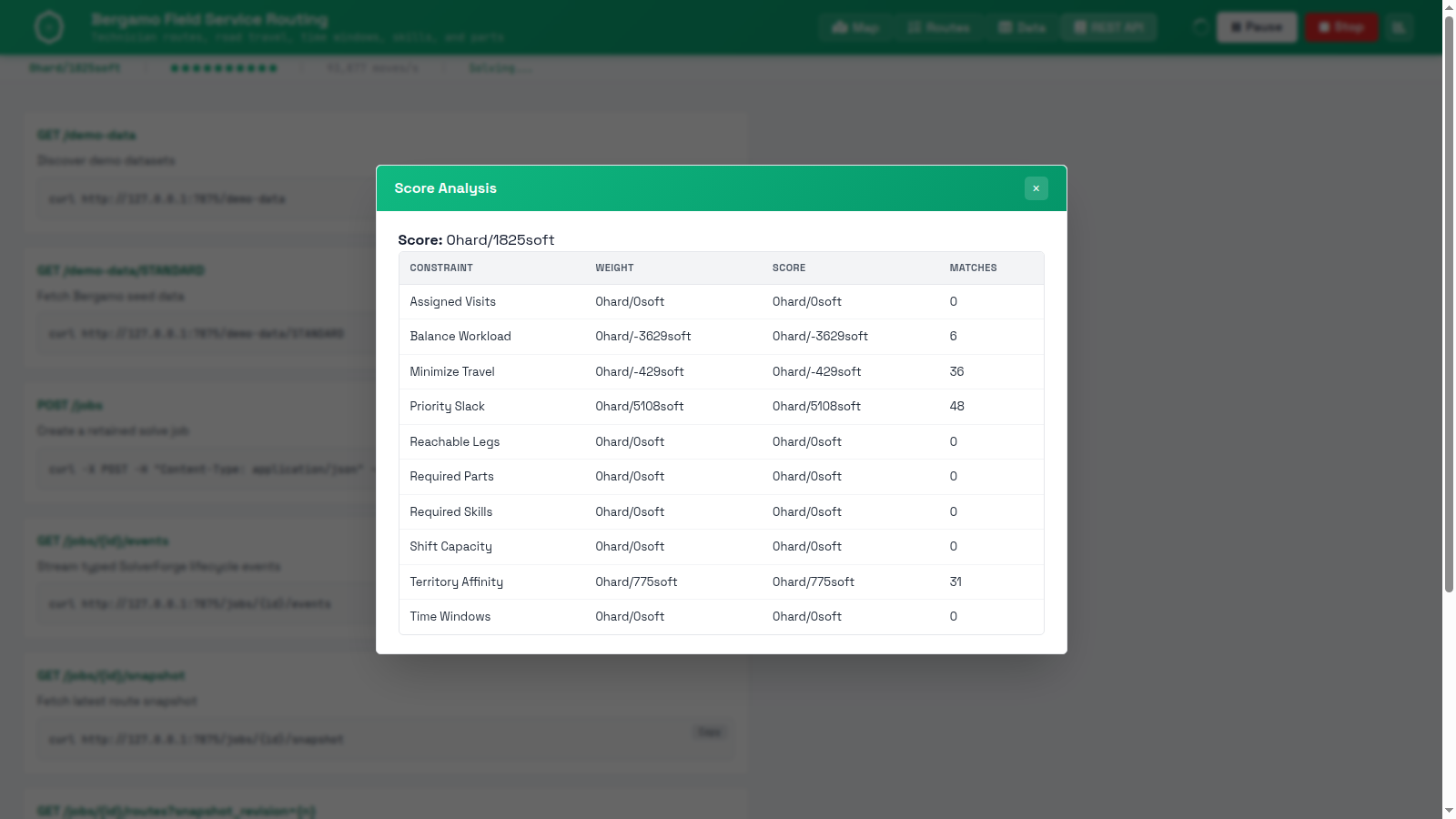

48 Bergamo service visits. 6 technicians. Skills, parts, shifts, and road-network routes.
Field service routing keeps technician-owned ordered routes together with skills, parts, time windows, shift capacity, territory preference, and route geometry.
This is not just dispatch. A valid plan has to decide which technician owns each visit, then order those visits against service duration, travel, time windows, skills, parts, shift capacity, and territory fit.

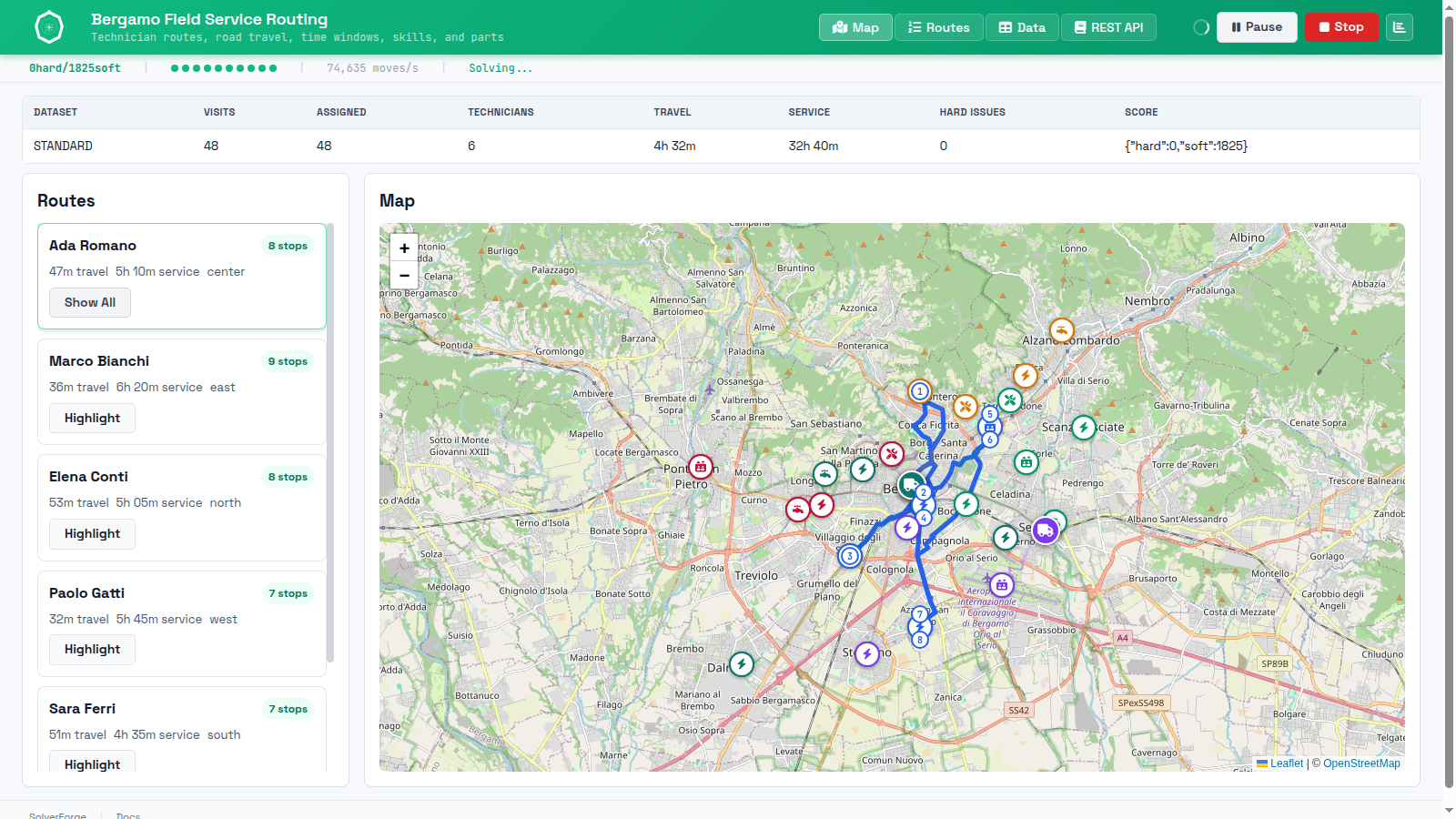

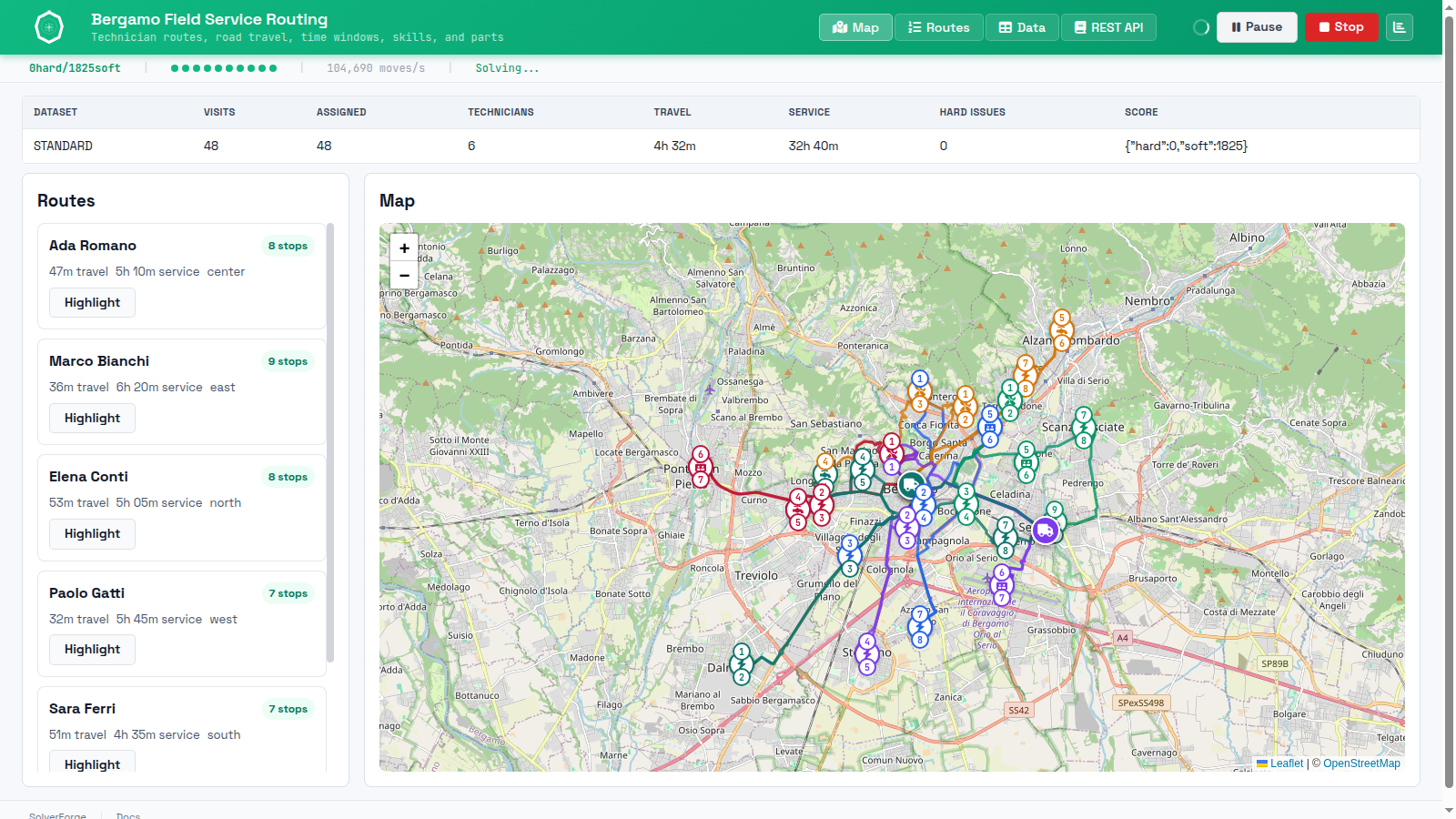

The current proof keeps map routes, technician route cards, a route timeline, data tables, score analysis, retained snapshots, route-geometry endpoints, and REST workflow on one inspectable surface.
- 1 The status and summary row expose assigned visits, hard issues, and current score without leaving the map.
- 2 Colored route geometry comes from the retained route snapshot, not a separate drawing layer.
- 1 Route cards expose technician, travel, service time, territory, and stop count.
- 2 Focused route markers and path geometry make the selected technician's ordered work inspectable.

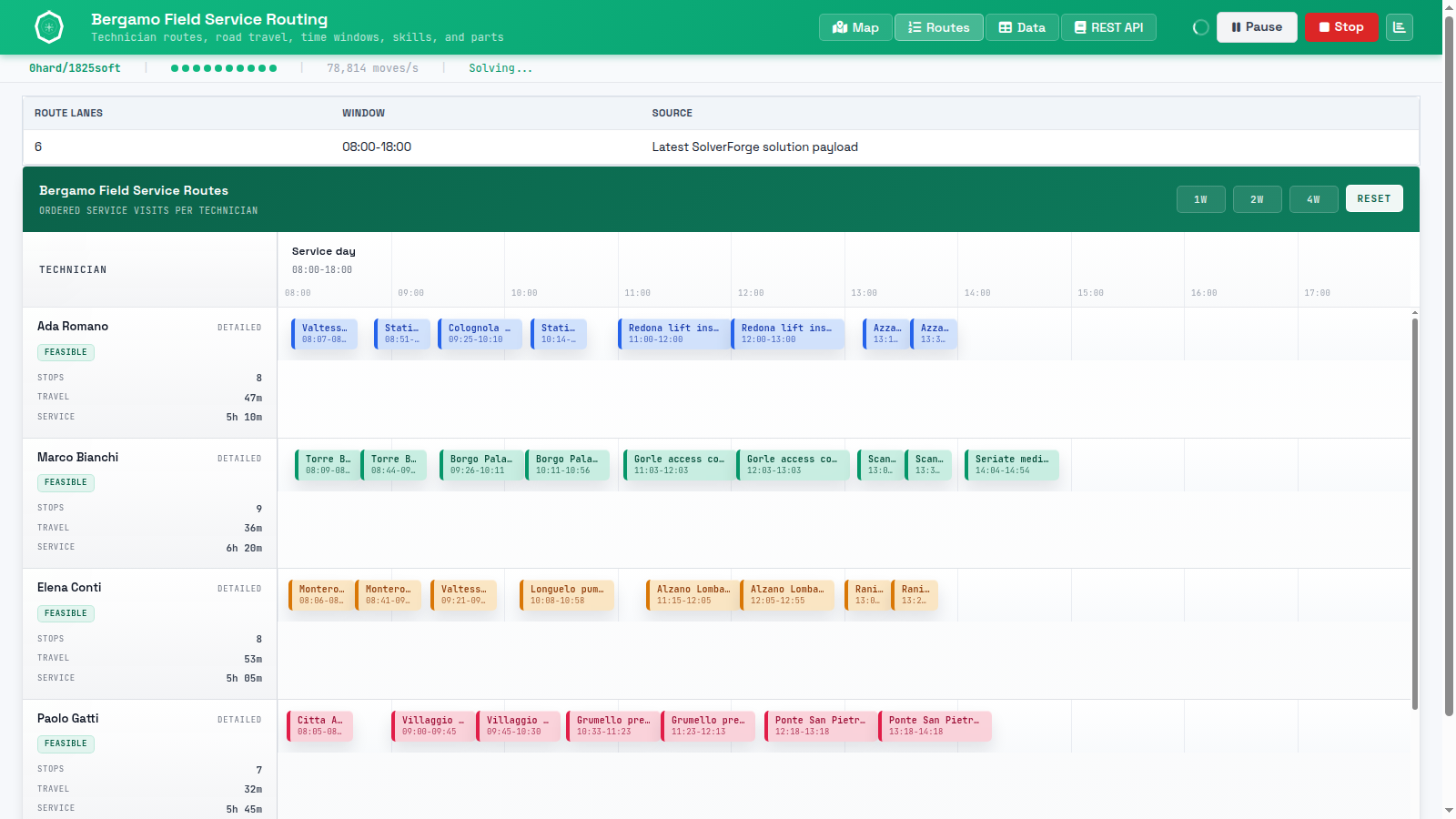

- 1 Each technician lane carries stops, travel, service time, and feasibility badges.
- 2 Visit blocks show the ordered route against the service-day clock.
- 1 Hard route legality and soft routing tradeoffs are separated in the analysis modal.
- 2 Match counts show where assignment, travel, priority, and territory pressure comes from.

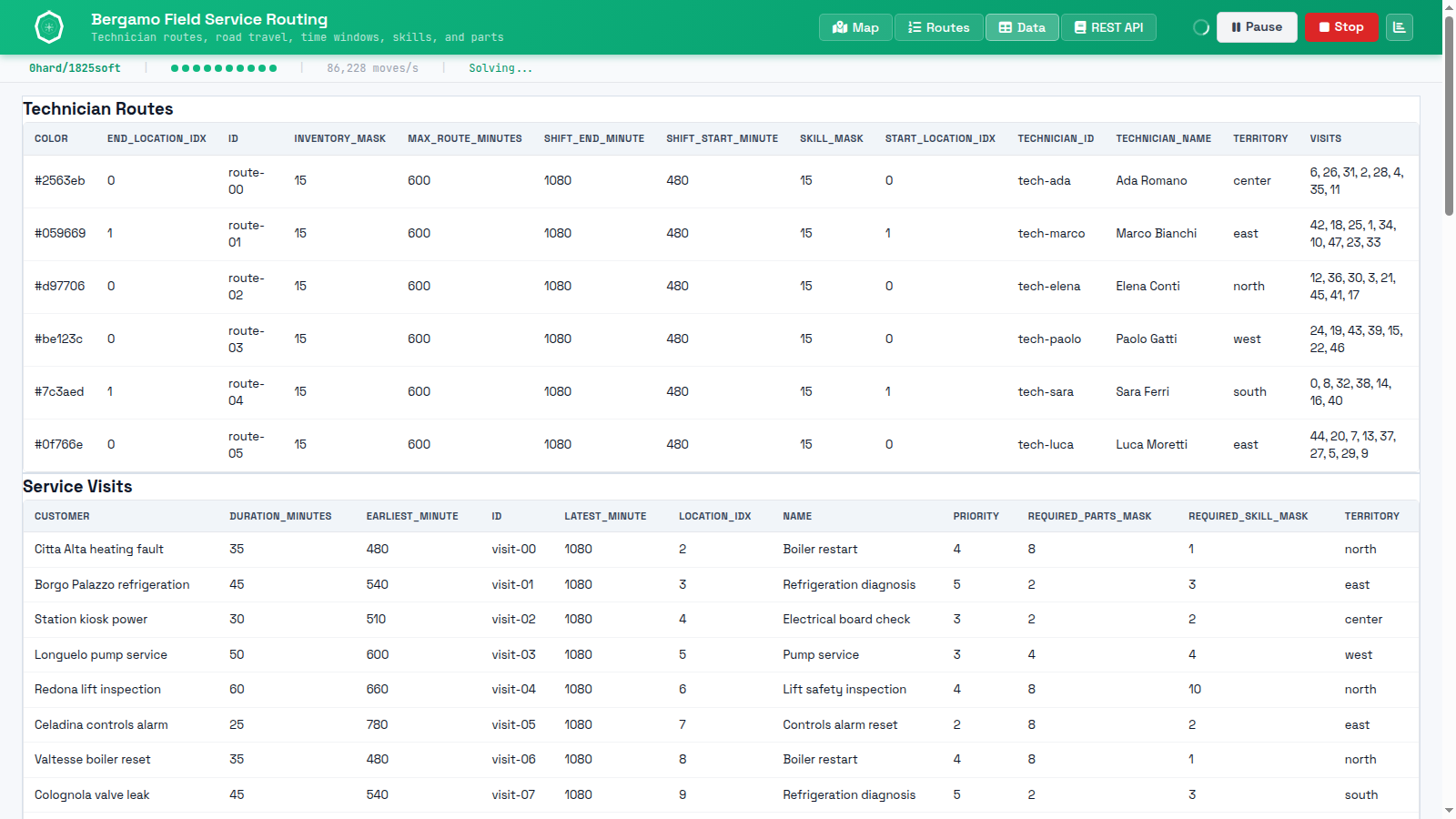

- 1 Technician-route rows expose shifts, skills, inventory, territory, and assigned visit order.
- 2 Service visits keep duration, windows, priority, skill masks, parts, and territory visible.

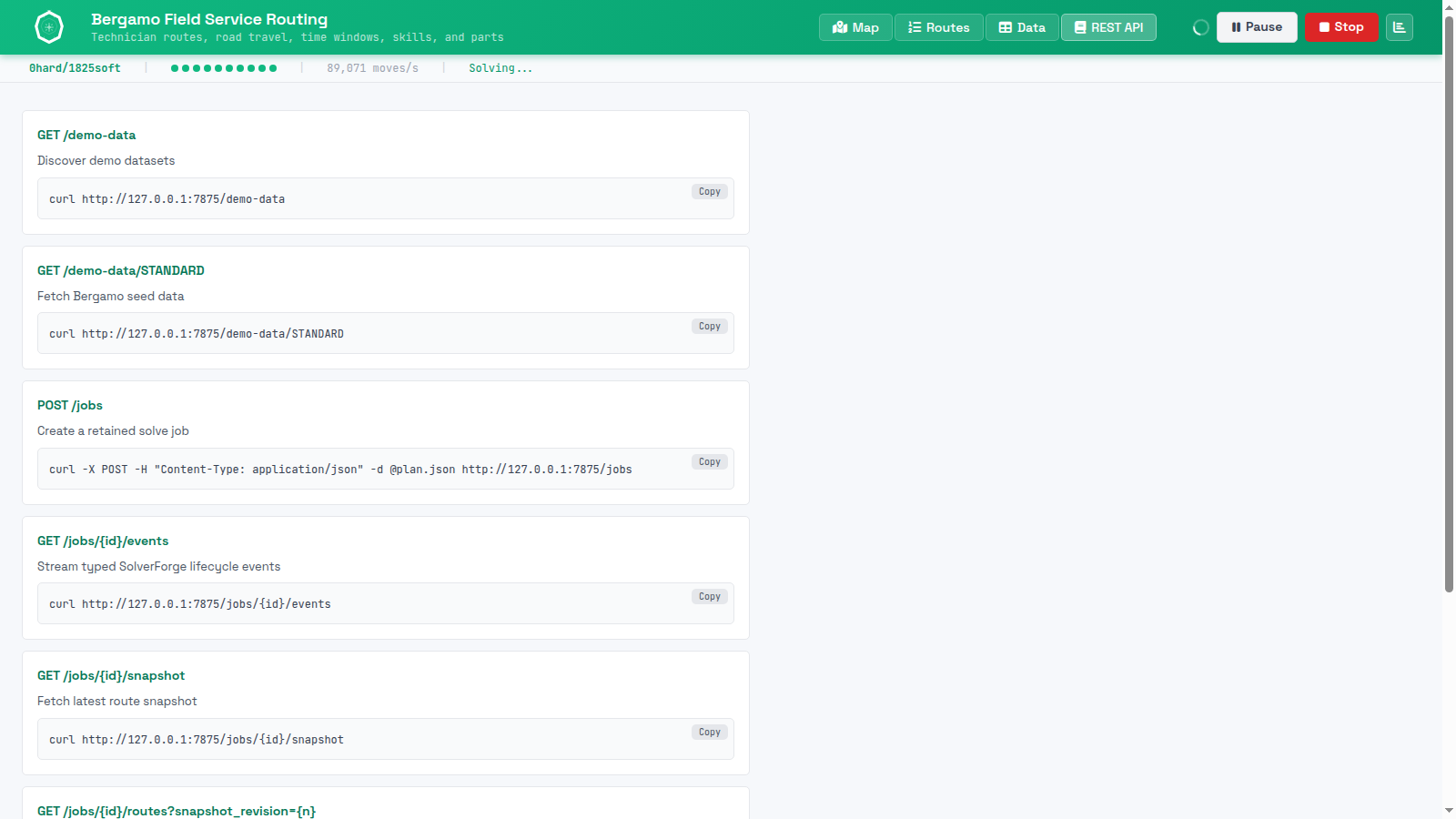

- 1 Retained-job endpoints expose creation, events, snapshots, and analysis.
- 2 Route geometry is available through a snapshot-scoped endpoint for product integration.
Industrial heat treatment
155 heat-treatment orders. 11 furnaces. 39 operators. One coupled plan.
Heat-treatment planning couples machine capacity, thermal sequencing, batch placement, task operators, monitoring load, and the shift roster into a single model, so a furnace plan that ignores operator coverage cannot look legal.
The answer is only valid if furnace assignment, time placement, task operators, monitoring capacity, and roster coverage all hold together. Staging those decisions can produce schedules that look legal in one layer and fail in another.
The app keeps the furnace timeline, the operator roster, the order table, score analysis, the retained job, and the REST surface inspectable from one operating artifact.
- 1 The status bar starts Ready with the score empty and all 30 constraint dots present.
- 2 Eleven furnace lanes wait for the solve; 155 orders are still unassigned.
- 1 Hard score is still counting down while the search is live.
- 2 Order blocks appear in the lanes as construction and local search place them.
- 1 Lane headers keep furnace type, maximum temperature, order count, and load capacity.
- 2 Each block carries its work-order code, customer, and process in the lane.
- 1 Operators carry role, availability, planned shifts, and their skill mask.
- 2 Every manual task must land on an operator rostered on the owning shift.
- 1 Assigned furnace and scheduled window are readable per work order.
- 2 Delay per order exposes whether priority-weighted lateness reached the plan.
- 1 Hard feasibility and soft operating pressure stay separated by type.
- 2 Every constraint reports its score and match count for review.
- 1 Every endpoint ships a copyable curl example.
- 2 Retained-job endpoints cover create, status, snapshot, analysis, and events.
Warehouse order picking
8 grocery orders. 145 pick items. 5 trolleys. One inspectable walking plan.
Order picking treats warehouse trolley routes as ordered lists: every item, bucket limit, order split, product location, and walking-metre tradeoff stays visible on the plan an operator would actually walk.
A picking plan is only useful if items are assigned to ordered trolley routes, the buckets can carry the grouped volume, and the walk is short enough to operate. Treating assignment and route order as separate cleanup steps makes the plan look tidy while order ownership or bucket capacity quietly fails.
The app keeps the isometric warehouse canvas, the trolley legend, the picking-plan cards, the input tables, score analysis, and the retained job on one surface.
- 1 The stats panel states the demand before the solve: orders, items, active trolleys, closed metres.
- 2 The warehouse canvas is drawn and waiting; no trolley route exists yet.
- 1 The solver is still improving, with the route plan changing under it.
- 2 Trolley paths and numbered pick markers appear as routes are constructed.
- 1 Coloured paths show trolley ownership; numbered markers expose the pick order itself.
- 2 The legend ties each colour to its trolley and item count.
- 1 Each trolley card carries its item count and bucket-volume capacity.
- 2 The ordered item list is numbered, so the walking sequence is explicit.
- 1 Scenario inputs are explicit: order count, trolley count, and bucket count.
- 2 Generate New rebuilds the dataset through the same demo-data contract.
- 1 required_buckets is the hard rule; bucket overflow is not a preference.
- 2 order_incidence and route_distance carry the soft pressure.
Asset readiness planning
24 vessels. 56 days. 66 decisions. Maintenance, training, and readiness in one plan.
Fleet readiness is a synthetic asset planner: work packages, inspections, training, docks, technician pools, parts arrivals, and daily readiness floors share one scenario surface and one repair workflow.
Readiness planning couples asset windows, dock compatibility, technician capacity, parts arrivals, inspection and training precedence, and daily readiness floors. Optimizing any one layer alone can make another infeasible.
The app keeps the vessel timeline, the daily readiness ledger, technician pressure, parts posture, disruption repair, score analysis, and the REST surface together.
- 1 The summary strip counts vessels, work packages, decisions, and dock utilization.
- 2 Every vessel lane is present and empty; nothing is silently pre-placed.
- 1 The solver is live and the score is still moving.
- 2 Work packages land in the vessel timeline as decisions are made.
- 1 Lanes show placement and readiness windows per vessel.
- 2 Blocks carry the work package, its class, and its priority on the day axis.
- 1 Readiness is reported per day across the full 56-day horizon.
- 2 The floor columns show the hard commitment the plan must hold.
- 1 Each pool reports its peak day and peak capacity.
- 2 Utilization and overtime headroom explain why the plan is constrained.
- 1 Four named disruptions describe the scenario before it is solved.
- 2 A repair seeds a baseline from the plan on screen and compares both revisions.
- 1 Nine hard rules cover assignment, windows, docks, precedence, capacity, parts, and readiness floors.
- 2 Soft objectives keep their weight, score, and match counts.
- 1 Retained-job endpoints cover create, status, snapshot, analysis, and lifecycle.
- 2 Every endpoint ships a copyable curl example.
Airline crew scheduling
10 flight legs. 24 crew. 42 required seats. Rotations that respect rest.
Crew scheduling fills every required cockpit and cabin seat while qualification, overlap, connection continuity, availability, and every rest and recovery window hold at the same time.
A valid rotation is more than a name in a seat. Every seat needs a qualified crew member, no two duties may overlap, connected flights must be operated in sequence, and each person has to be available. Rest is where it gets hard: home-base and away-base minimums, 36-hour extended recovery, and 48-hour recovery after long-haul duty all hold together.
Solve those rules one at a time and you get a roster that looks fine in one view and strands a crew member in another. The app keeps the crew timeline, the by-flight manifests, score analysis, the data tables, and the retained job in one model.
- 1 Required seats and unassigned seats are stated before the solve.
- 2 Crew lanes carry home base and role; no duty block exists yet.
- 1 Duty blocks land in crew lanes as seats are assigned.
- 2 The solver is live and the score is still improving.
- 1 Lane headers keep each crew member's role, home base, and flight count.
- 2 Duty blocks sit against the day axis, with unavailable days overlaid.
- 1 Each row is one flight leg with its seat requirement.
- 2 Seat blocks name the crew members assigned to that leg.
- 1 Coverage, skill, overlap, connection, availability, and rest are hard rules.
- 2 Home-base return stays visible as soft pressure on its own.
- 1 Crew assignments expose which employee owns which required seat.
- 2 Employees carry qualifications and home base as input facts.
- 1 Retained-job endpoints cover create, status, snapshot, and analysis.
- 2 Lifecycle actions and the event stream are integration points as well.
Electric-van delivery routing
48 pharmacies. 6 electric vans. 14 chargers. One plan that never runs a battery flat.
EV routing plans one delivery day around Bergamo: which van serves each pharmacy, in what order, and where it stops to charge, with capacity, delivery windows, real road travel, and battery range held together in one score.
An electric delivery route is only valid if the van can actually drive it. A route that fits capacity and every delivery window can still run below the battery reserve halfway through, and adding a charging stop moves every later arrival. Visit order, charging, and lateness have to be decided together.
Charging stops are derived rather than searched: after every route change an exact dynamic program places the stops that minimise range shortfall and then added time, so the list variable holds only pharmacies and the stock Clarke-Wright and k-opt construction works unchanged. The app keeps the route map, the van cards, the schedule, the input tables, score analysis, and the retained job on one surface.
- 1 The fleet figures start at zero: distance, driving, charging stops, shortfall, lateness.
- 2 Hub, pharmacies, and public chargers are placed on the real road map.
- 1 The retained job is still solving; Pause and Stop stay available.
- 2 Routes follow the road network; legs to and from a charger are dashed.
- 1 Each card states load, distance, charging stops, lowest charge, and return time.
- 2 Pharmacies take their van's colour; used chargers are coloured too.
- 1 Battery shortfall is a hard rule, measured in metres below the reserve.
- 2 Total travel time carries the soft cost: driving plus charging.
- 1 Charging stops sit in the timeline where the route places them.
- 2 Each lane is one van, with its stop and charge counts.
- 1 Vans differ in capacity, range, starting charge, and recharge time.
- 2 Pharmacies carry crates, a delivery window, and an unloading time.
Built on SolverForge · personal planning
Your tasks, your meetings, your hours. One week you approve.
Planner123 is a keyboard-driven terminal calendar with a SolverForge planner built in. It reads your real calendar, places unscheduled tasks inside the hours you declared, and writes nothing until you approve the proposal.
A calendar remembers what is already scheduled. The Planner Inbox holds the other kind of work: tasks with a duration, a priority, a cognitive load, and a deadline, but no time yet. Press o and the solver proposes a start for every task it can place; press A and only then do the tasks become events.
The model is one scalar planning variable per task, its start slot, and it may stay unassigned when the week is full. Existing events are busy time, availability always wins, deadlines outrank deep-work preferences, and the proposal changes nothing until it is applied. Events live in a local SQLite file, and every action is also a JSON command, so an agent can drive the same workflow.
The real app
Built on SolverForge · Hermes Agent plugin
Your tasks, around your meetings. On your calendar after you say yes.
SolverForge Planner is a Hermes Agent plugin. Ask Hermes to plan your week: it pulls your calendar, a SolverForge engine fits every task into free working time, and the plan reaches your calendar only after you approve it.
You tell Hermes what needs doing in plain words: durations, deadlines, task order, the hours you work and the hours you focus best. Hermes pulls your cloud calendar as busy time, the engine places every task it can, and the plan card in the chat shows the score and each block on the week. A score of 0hard means no hard rule is broken; when a task cannot fit, you are told which one and why.
Nothing is written until you approve the exact blocks. Applying puts the plan on the planner's own local calendar; pushing puts it on yours through the calendar tool Hermes already uses. Every block has a fixed event ID, so pushing twice adds nothing, and the planner only ever creates, moves, or deletes its own events. In Hermes Desktop the week and the tasks dock in a pane beside the chat, which opens from the plan card or the status-bar chip.
The real app
Built on SolverForge · Hermes Agent plugin
Tell Hermes where you need to go. Get the order, on real roads.
SolverForge Routing is a Hermes Agent plugin for personal multi-stop driving trips. Hermes finds the places, a SolverForge engine orders the stops on OpenStreetMap roads, and the road map opens beside the conversation.
You give Hermes the places, a start, and where the day should end. It searches each place, shows the matches with their type, locality, and distance, and adds nothing until you confirm. The engine builds a road graph from OpenStreetMap with solverforge-maps, and the same graph supplies the travel-time matrix and the geometry of each hop, so the map draws the roads you would drive.
Plans change in the conversation: skip a stop, choose the first visit, add a place, finish somewhere else. The trip is repaired, keeping visited stops, the next visit, and any before rules, and an older solve never overwrites a newer edit. Results are labelled best-found, not proven optimal. The itinerary opens in Google Maps, Apple Maps, or OpenStreetMap, or on your phone through one QR code at a time.
The real app
Run one yourself
Run these examples, then model your own decision.
Every case above is a working app you can read and run: four with a written guide and a Hugging Face Space you can drive in the browser, the rest with their source. Scaffold the generic project shell, follow one worked example, or start from a Space.
